NE 130th St & NE 125th St Mobility and Safety Project

Updated April 17, 2026

What's Happening Now?

Sign up for email updates to get the latest construction and project news.

Upcoming Changes to Traffic Control

Starting as soon as the week of April 27, the westbound lane on Roosevelt Way NE/NE 125th St will close between 15th Ave NE and 10th Ave NE. This traffic control change is weather dependent. Details and detour map are below.

Upcoming Construction

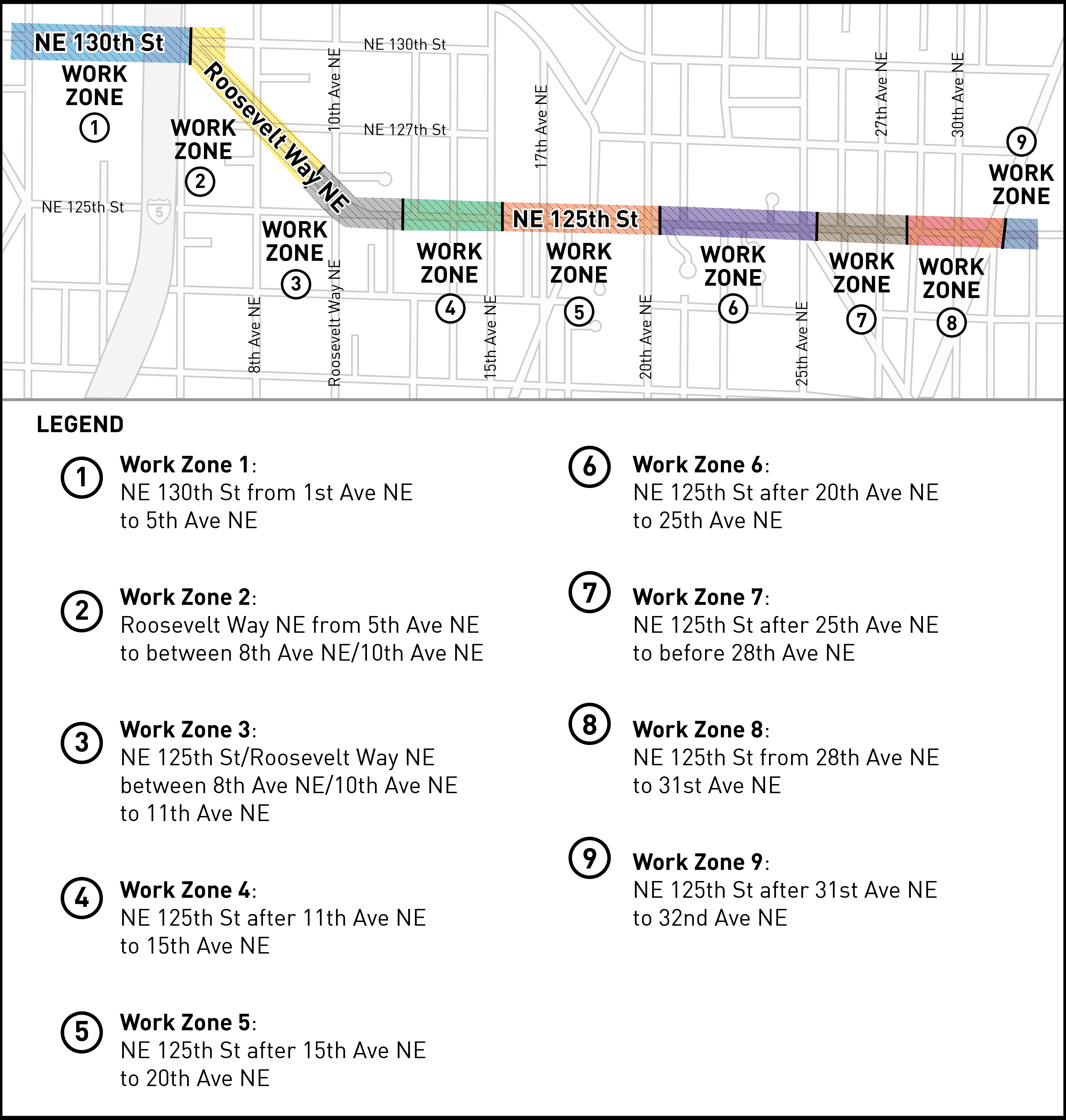

Work Zone Map

Map showing project work zones

Week of April 20

  • Concrete pouring for the roadway and sidewalk at 10th Ave NE (Work Zone 3) and 27th Ave NE (Work Zone 7)
  • Landscaping and irrigation work at 10th Ave NE (Work Zone 3)
  • Protected bike lane work at 8th Ave NE (Work Zone 2), 15th Ave NE (Work Zone 4), 20th Ave NE (Work Zone 5), and 23rd Ave NE (Work Zone 6)
  • Underground utility work at 1st Ave NE (Work Zone 1), 8th Ave NE (Work Zone 2), and 10th Ave NE (Work Zone 3)

Week of April 27

  • Westbound closure of Roosevelt Way NE/NE 125th St begins. Read below for more details and a detour map.
  • Concrete pouring for the roadway and sidewalk at 10th Ave NE (Work Zone 3) and 27th Ave NE (Work Zone 7)
  • Protected bike lane work at 10th Ave NE (Work Zone 3)
  • Concrete pouring for bus shelters on sidewalks at 15th Ave NE (Work Zone 4), 20th Ave NE (Work Zone 5), and 23rd Ave NE (Work Zone 6)
  • Demolition and underground utility work at 32nd Ave NE (Work Zone 9)

What to Expect During Construction

  • Temporary Metro bus stop relocations March 13 to May 1:
    • 25th Ave NE (Work Zone 6) westbound (Stop #35233) and eastbound (Stop #35420) routes
    • 28th Ave NE (Work Zone 7) westbound (Stop #35213) and eastbound (Stop #35440) routes
  • Weekend working hours of 7 AM – 7 PM
  • Typical weekday working hours of 7 AM – 5 PM
  • Lane shifts, closures, temporary detours, and short delays in active work zones. Flaggers will direct traffic as needed.
  • Steel plates on roadway that can be slippery. Please be alert when traveling through the project area.
  • Barrier-separated paths for people walking, biking, and rolling through the construction area
  • Parking restrictions near the project area for material and equipment storage
  • Noise, dust, and vibrations during active construction
  • Impacts to bus stops. Please visit King County Metro’s Service Advisories page for current route and stop information.

Westbound Lane Closure on Roosevelt Way NE/NE 125th St: Week of April 27

We will close Roosevelt Way NE/ NE 125th St to westbound travel between 15th Ave NE and 10th Ave NE starting as soon as the week of April 27. We expect this closure to last until June.

The road will be reduced to one lane and one-way for eastbound travel. Travelers heading westbound on Roosevelt Way NE/NE 125th St must detour onto 15th Ave NE to access beyond 10th Ave NE. Local access of westbound Roosevelt Way NE/NE 125th St is maintained between 11th Ave NE and 15th Ave NE (Work Zone 4). This traffic control change is weather dependent.

Closures

  • No westbound travel on Roosevelt Way NE/ NE 125th St beginning at 15th Ave NE and continuing through the roundabout area in Work Zone 3 and 4. Detours are required.

Detour Information

  • Travelers heading westbound on Roosevelt Way NE/ NE 125th St must detour onto 15th Ave NE to access beyond 10th Ave NE in Work Zone 3
  • Eastbound travel through Work Zones 3 and 4 is fully maintained during the closure

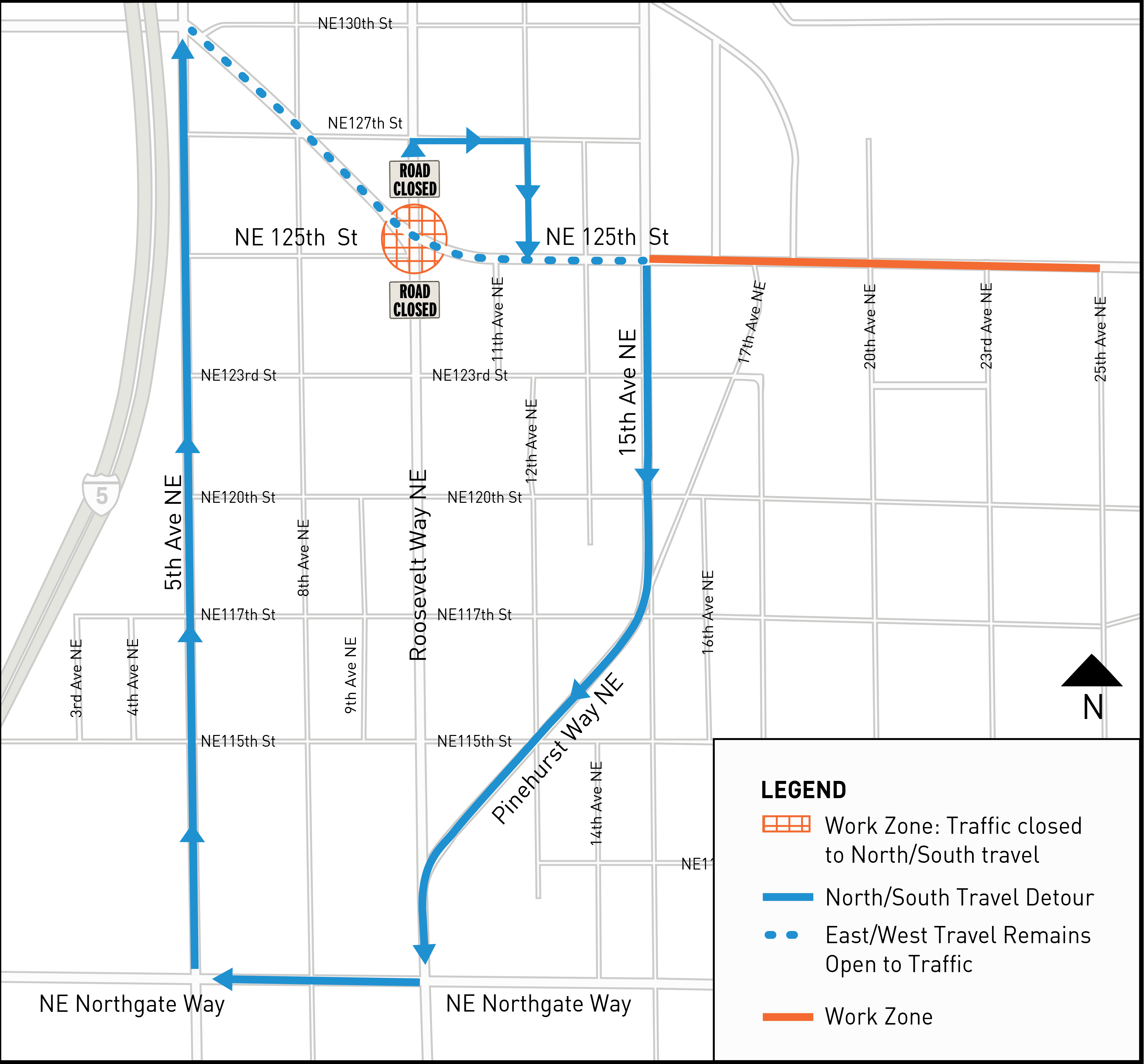

Detour Map

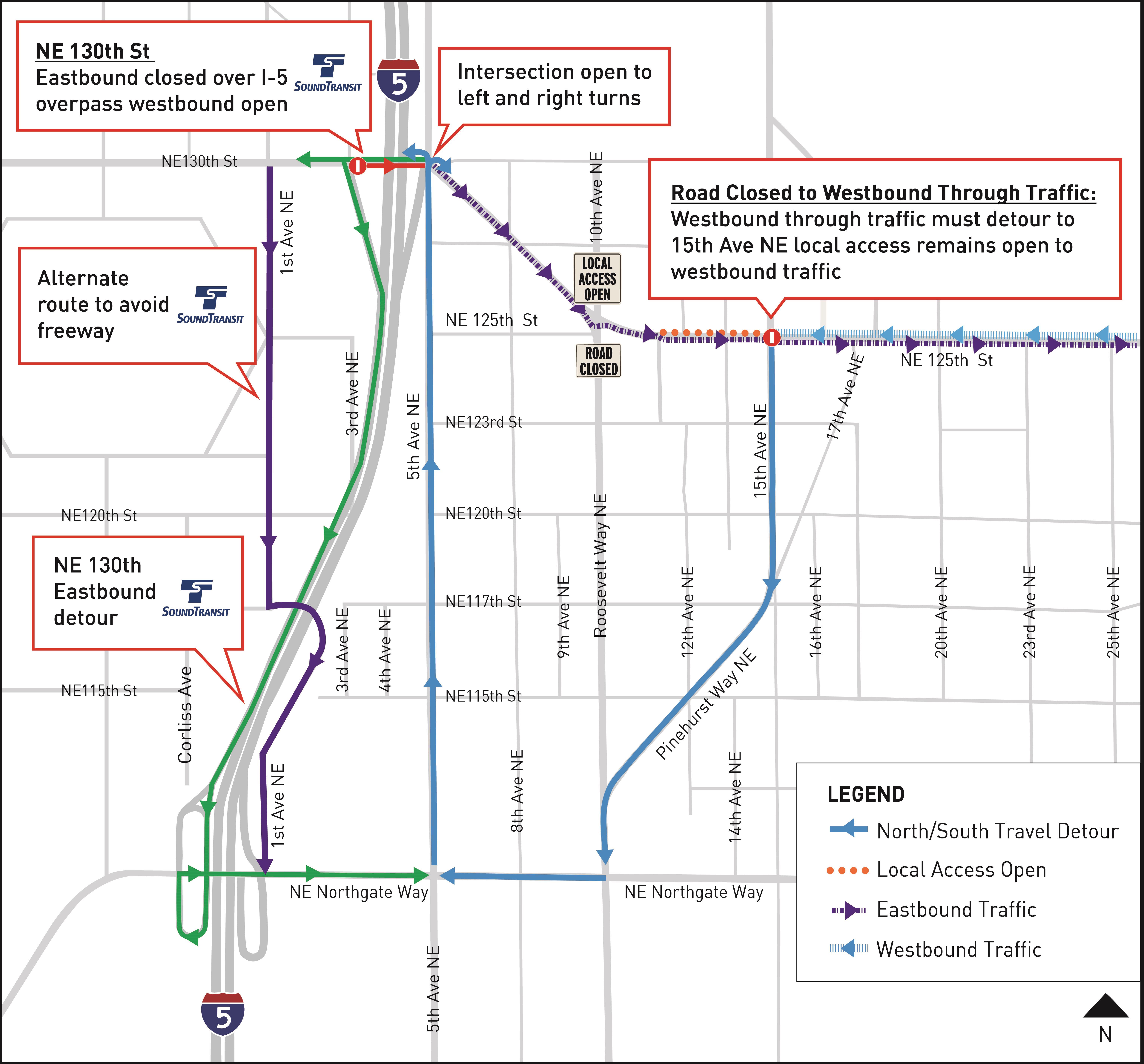

Map showing closures and detours

Translation services available

Please let us know if you need translation or language services. You can call or write to us in any language.

Project Overview

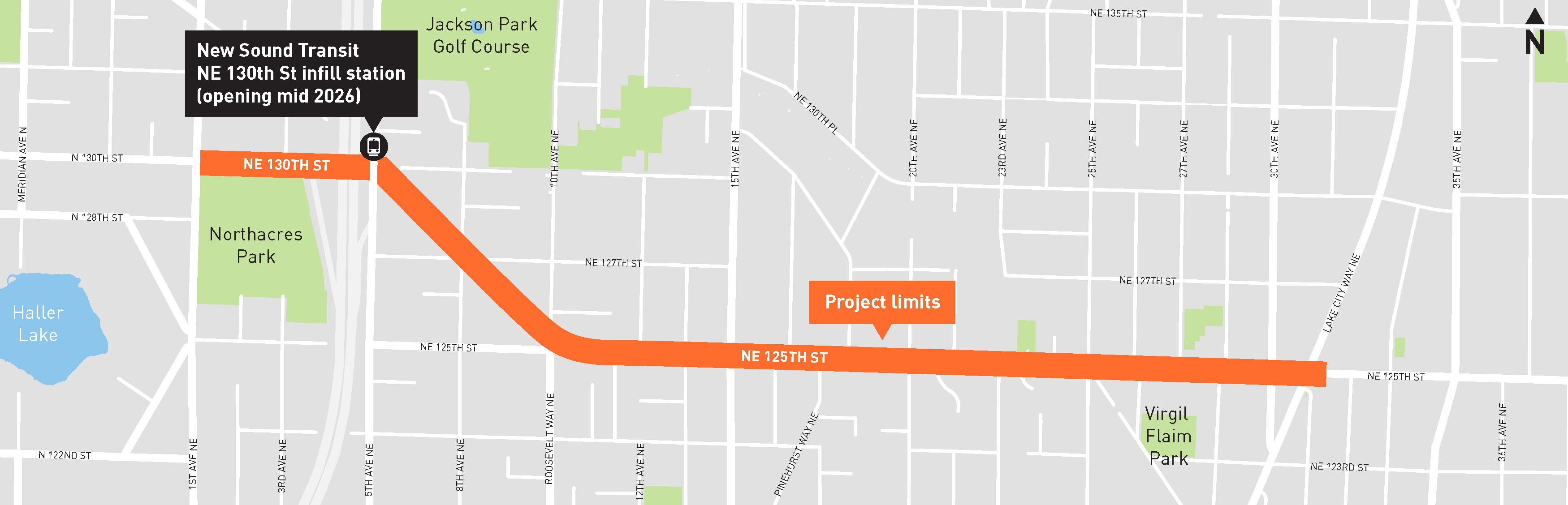

This project map shows the new light rail station and the streets where project elements will be built. The project area starts at NE 130th St and 1st Ave NE, heading southeast along Roosevelt Way NE, and then east along NE 125th St, ending east of Lake City Way NE.

Sound Transit is opening the Pinehurst Station in 2026 and expects 90% of daily riders to get to the station by walking, biking, rolling, or taking the bus. We’re making it safer and easier to get to the station and around your neighborhood with improved crossings, a new street design, traffic calming, curb-protected bike lanes, and upgraded/new bus stops. These improvements on NE 130th St, Roosevelt Way NE, and NE 125th St from 1st Ave NE to Lake City Way NE support our Vision Zero goals to prevent serious and fatal crashes.

Project Improvements

Safety

  • Safety redesign of the street to have 1 vehicle lane in each direction, protected bike lanes/facilities, and a center turn lane. This redesign will make it safer to make left turns and reduce conflicts between people driving and people walking, biking, or rolling.
  • Redesign of 3rd Ave NE & NE 130th St to “right out only” from 3rd Ave NE with a raised crossing for the shared-use path to prevent collisions and calm traffic
  • New roundabout at Roosevelt Way NE & 10th Ave NE to improve traffic flow and safety. The roundabout includes flashing crossing beacons and concrete curb protected bike lanes. Learn more about routing options when the roundabout opens.
  • Traffic calming with speed cushions (speed humps) and turn lane medians to prevent passing in some places
  • Upgraded intersections and signals to improve traffic flow and safety for all users

Walking, biking, and rolling

  • Raised 12-ft wide shared-use path for people walking, biking, and rolling on the north side of NE 130th St from 1st Ave NE to 5th Ave NE
  • 2-way bike lane with concrete curb barriers on the north side of the street from 5th Ave NE to 8th Ave NE to transition people between the shared-use path and the directional bike lanes east of Roosevelt Way NE & 8th Ave NE
  • Directional bike lanes with concrete curb barriers from Roosevelt Way NE & 8th Ave NE to NE 125th St & Lake City Way NE. Curb barriers are extended through the Roosevelt Way NE roundabout.
  • Sidewalk repairs and new ADA-accessible curb ramps in some places
  • New full traffic signal at 8th Ave NE and Roosevelt Way NE to support bike crossings
  • Rectangular Rapid Flashing Beacons at the Roosevelt roundabout and on NE 125th St at 20th Ave NE and 23rd Ave NE
  • Upgraded crossing signals and Leading Pedestrian Intervals that give people walking and rolling a head start in some locations

Transit

  • Bus only lanes on the I-5 overpass and near Lake City Way NE to help with bus reliability
  • Upgraded and new bus stops to support King County Metro’s new Route 77, including new bus shelters with lighting and raised bike lane crossings to make it easier for people to cross the bike lane
  • Bus signal priority upgrades that give buses a head start

Project Design

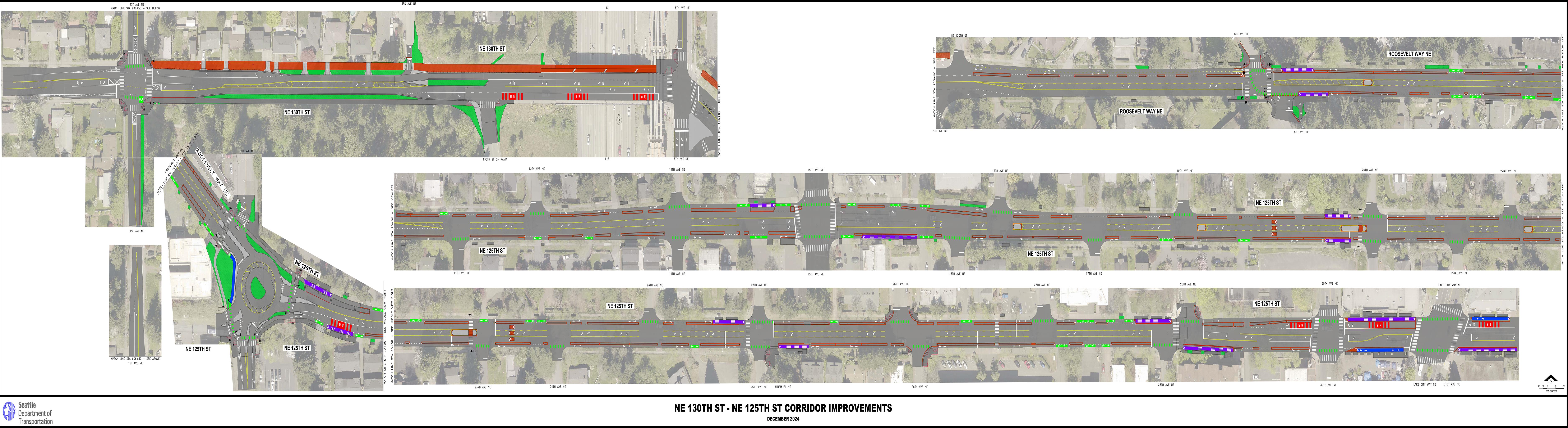

Map showing project limits and features

(Click to enlarge)

Key project sections (click to enlarge)

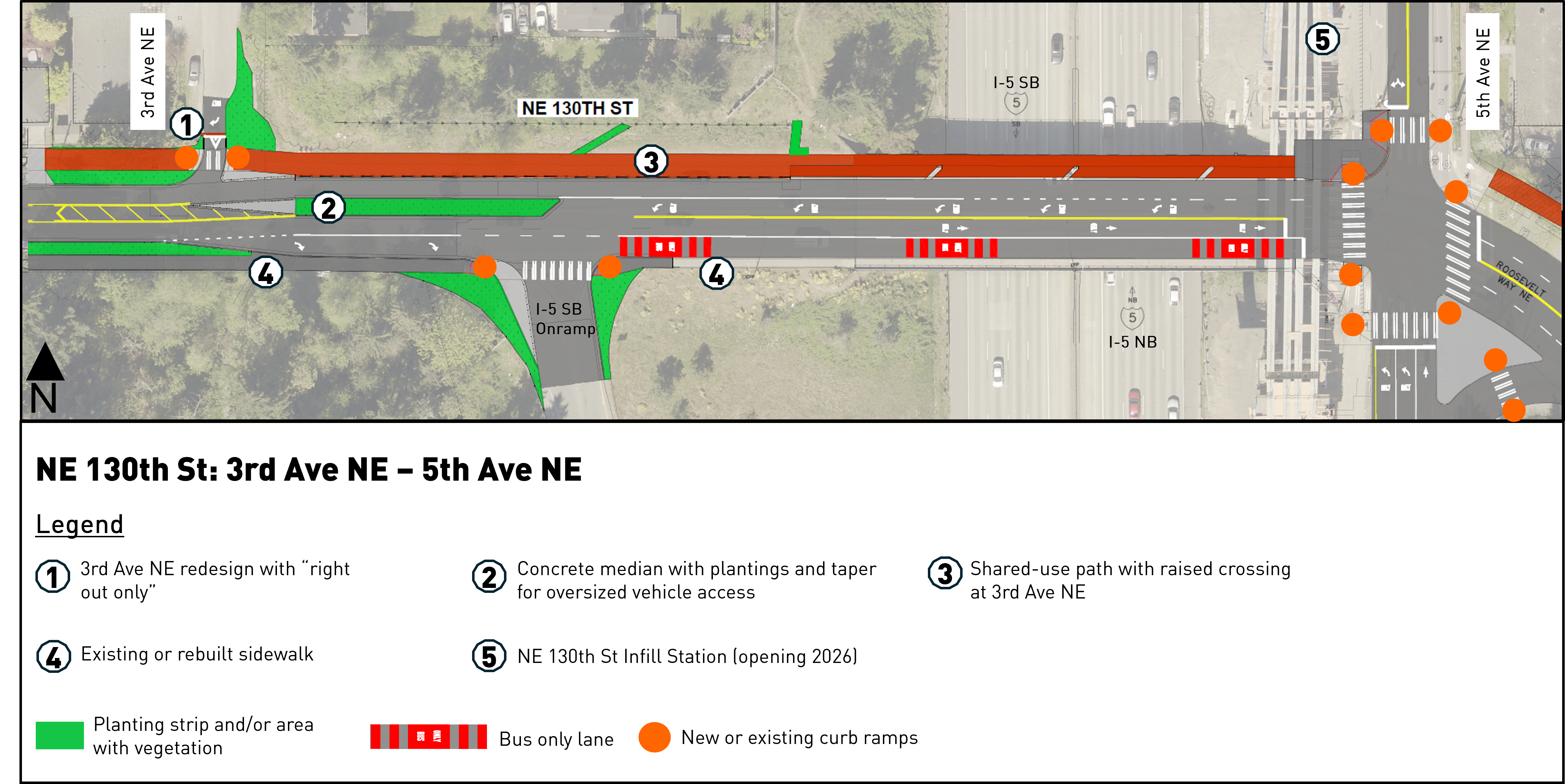

NE 130th St: 3rd Ave NE - 5th Ave NE

NE 130th St: 3rd Ave NE - 5th Ave NE image

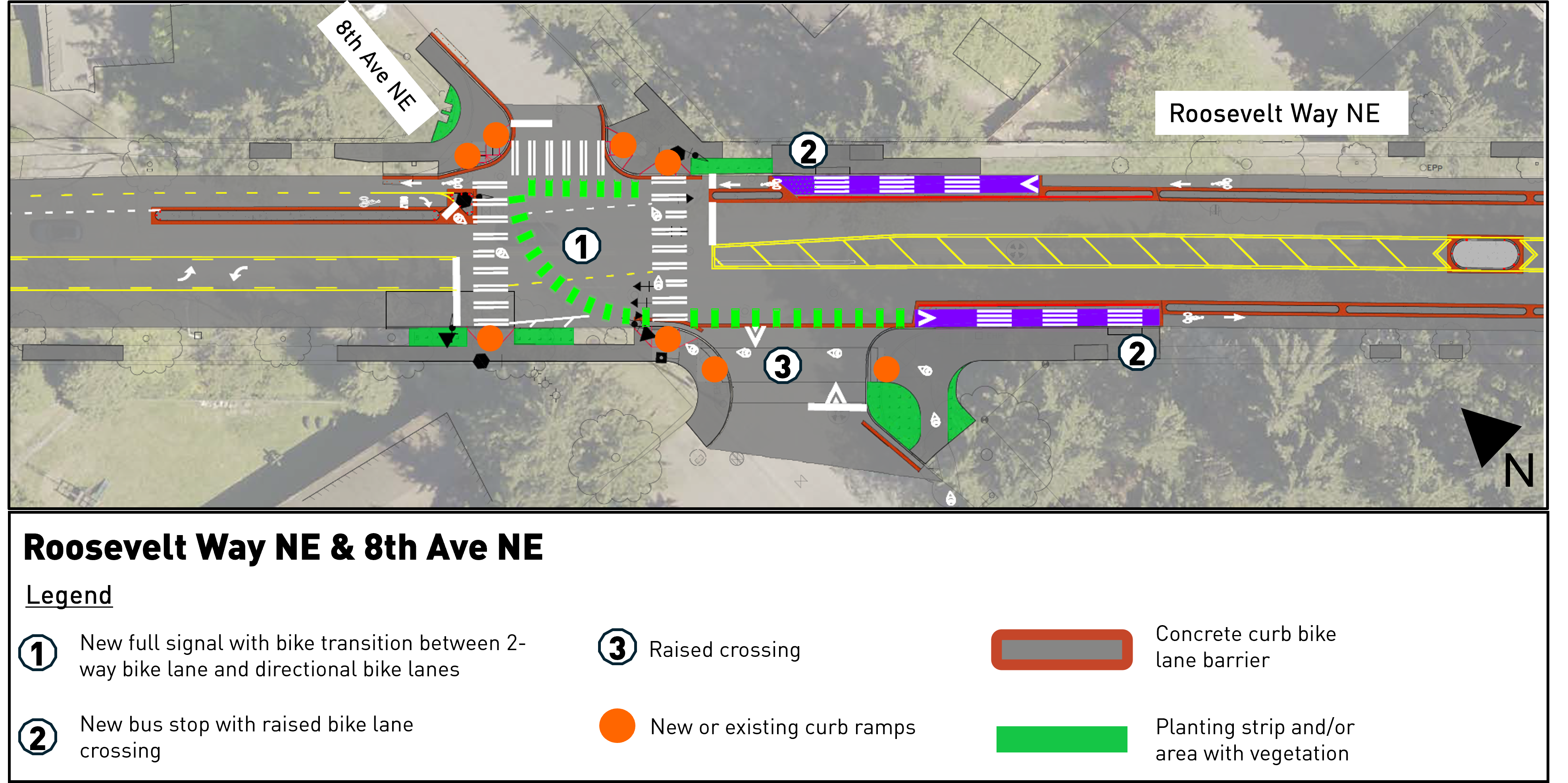

Roosevelt Way NE and 8th Ave NE

Roosevelt Way NE and 8th Ave NE work map

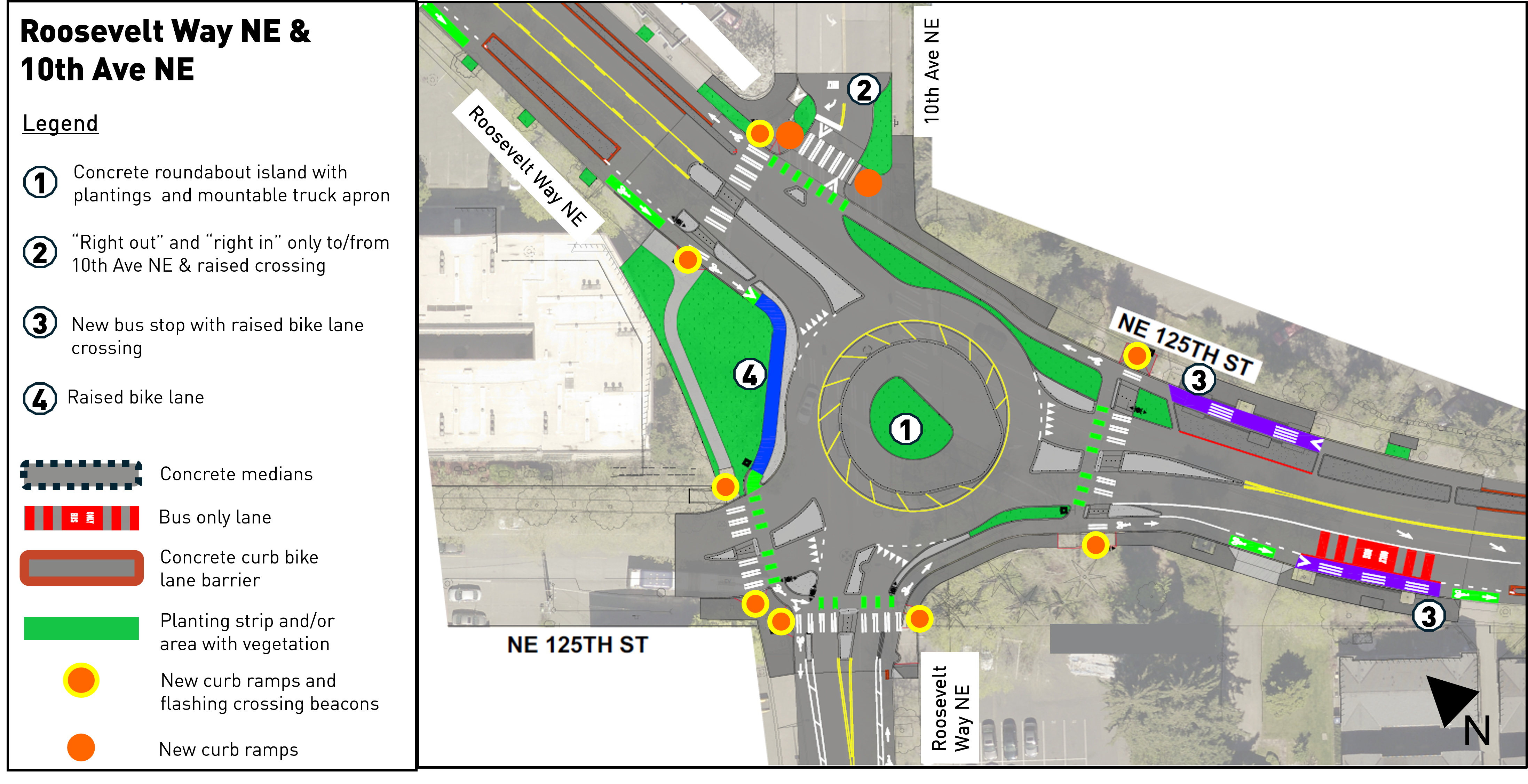

Roosevelt Way NE Roundabout

Roosevelt Way NE Roundabout image

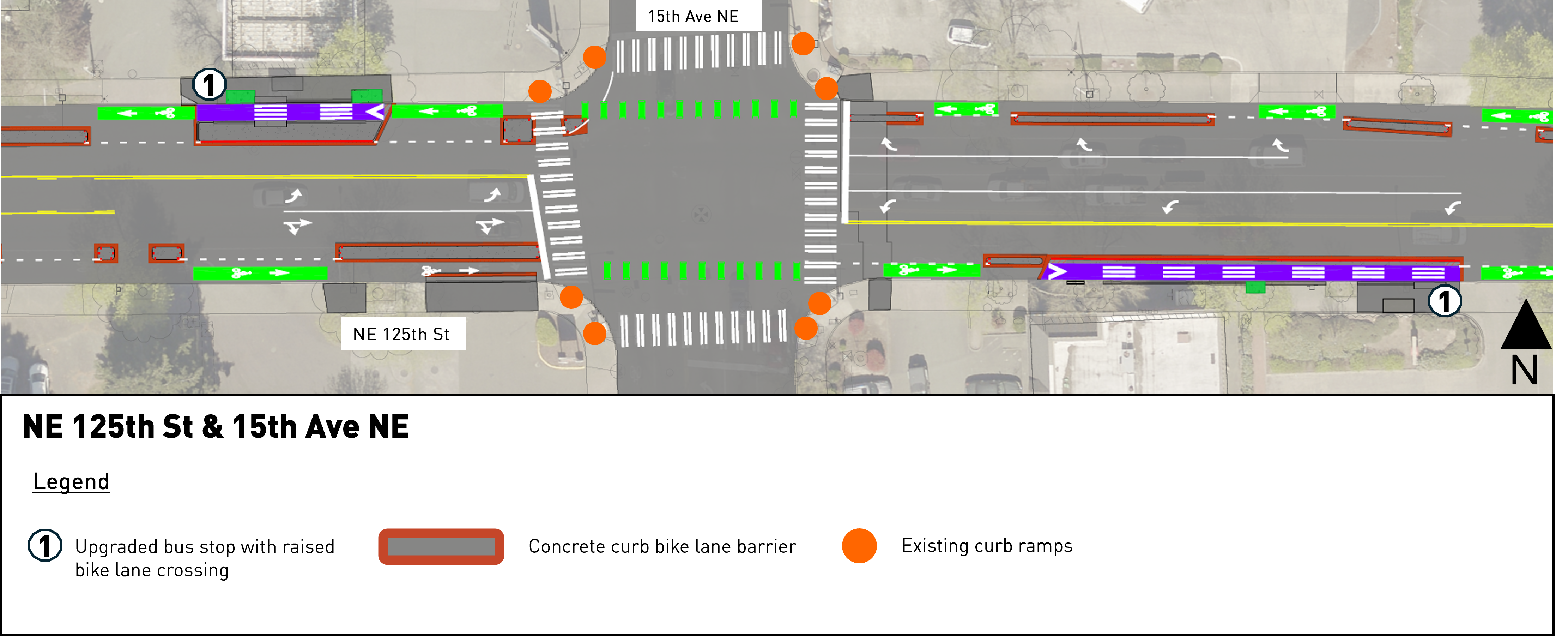

NE 125th St and 15th Ave NE

NE 125th St and 15th Ave NE image

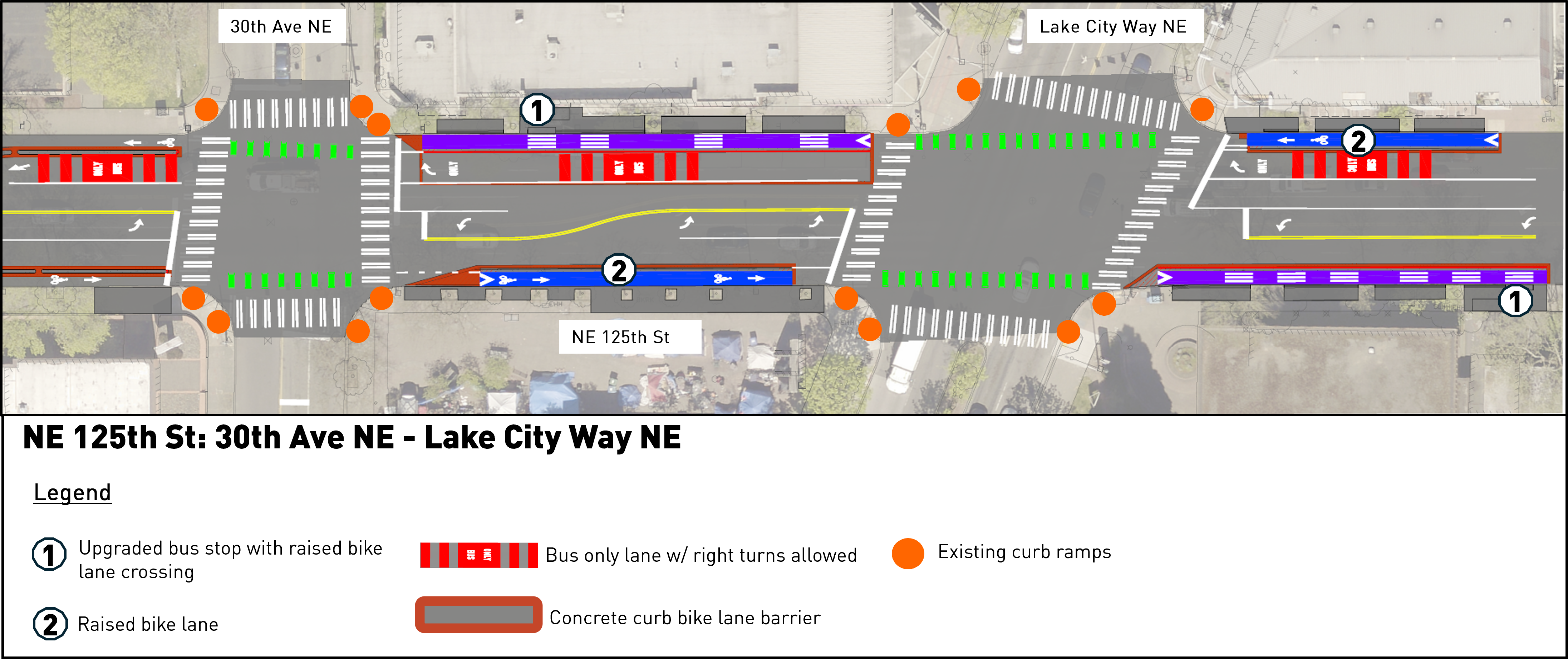

NE 125th St: 30th Ave NE - Lake City Way NE

NE 125th St: 30th Ave NE - Lake City Way NE image

Schedule

  • Planning (2023): We talked to community members and businesses to build on previous planning and community engagement work done in the area. Learn more about planning work in the Project Background section.
  • Design (2023-2024): We created and shared design proposals and gathered community feedback to reach the final project design. Read our Outreach Summary  to learn about how we engaged with people through the design process.
  • Construction (2025-2026): Construction started in November 2025 and will last approximately 1 year*

*Construction schedules are subject to change based on crew and material availability.

Project Background

The NE 130th St & NE 125th St Mobility and Safety Project design was based on early planning efforts for the NE 130th St and NE 148th St light rail stations. Two studies were done by the Seattle Department of Transportation (SDOT) and the Office of Planning and Community Development (OPCD) that identified safer streets and crossings, upgraded walking and biking facilities, and better connections to neighborhood services as priorities.

  • NE 130th St & Shoreline South/NE 148th Stations: Multimodal Access Study: In 2020, SDOT worked with community members on a study of areas around the two new light rail stations. The study came up with 18 ideas for projects for the two new light rail stations. Three of the ideas (#1, #15, and #17) are part of the NE 130th St & NE 125th St Mobility and Safety Project.
  • 130th and 145th Station Area Planning: In 2019, OPCD started planning for the 130th & 145th (now called the 148th) Light Rail Station areas. This process brought together community members, City of Seattle staff, and other public agencies to talk about the changes these new light rail stations will bring to the region.

Nearby Projects

Project Library

Outreach Summaries

Project Design
